How to Minimize Web Design Delays From Review and Approval Cycles

Author: Bill Ross | Published: June 18, 2026 | Updated: June 18, 2026

Students Collaborative Study Session Neon Ring Cyan Emulent
Most web design delays do not come from slow designers. They come from review and approval cycles: the rounds of feedback, the sign-offs, and the waiting in between. A redesign that should take eight to twelve weeks can stretch well past that when feedback is slow, scattered, or routed through too many people. The good news is that this is the most fixable part of any website project, because the levers sit with you, not with the build. Here is how to keep a website launch on schedule by changing how review actually works.

  • Measure the right thing. Track time-to-launch and what the live site earns, not how many feedback rounds a project survived or how thorough the review felt.
  • Build review as a system. A repeatable structure with one owner, one feedback queue, and a cap on rounds stops review from being improvised on every project.
  • Decide who approves. Every extra approver adds weeks, so limit sign-off, cap the rounds, and keep input separate from approval.
  • Own your review window. Most delay sits on the decision side, not the design side, so name one decision-maker and block real calendar time for feedback.
  • Be honest about tools. Software and AI help at the margins, but a human decision is the real bottleneck, and tool adoption is already near its ceiling.

Measure outcomes, not how many rounds a project survived

The first problem is what teams count. Many measure review by how careful it feels: the number of comments, the rounds of feedback, the layers of sign-off a project passed through. None of that tells you whether the project is healthy. A site can clear six rounds of review and still launch late, off-brand, and unable to convert. What matters is whether the work shipped on time and whether the live site does its job. If you build a fast, polished website that brings in traffic but does not convert, the review process did not protect you, no matter how rigorous it looked.

A short set of metrics tells you far more than round counts. Watch these:

  • Approval cycle time. The average days from brief to final sign-off, split by content type. Low-risk pages should clear in two to three days, and higher-risk content with legal review in five to seven. When that runs to two weeks, the cause is usually unclear ownership, not the work itself.
  • First-time approval rate. The share of pages approved on the first pass. This is your clearest signal that locked briefs and templates are doing their job.
  • Revision rounds per page. Two to three rounds is the healthy range. Three or more usually points upstream to a vague brief or missing brand assets.
  • Time-to-launch. The number that the business actually cares about, and the one round counts quietly hide.

Stacked Bar Chart Comparing Where The Weeks Go In A 12-Week Website Redesign, Showing That Build Work Is Identical Between Ad-Hoc Email Review And A Structured Queue, And That The Entire Difference Is Waiting Time.

When you map where a typical redesign spends its weeks, the pattern is clear: the build work is roughly identical whether review is loose or tight. The whole difference is waiting on decisions and content. Chasing the number of feedback rounds treats a symptom. Counting how many days the project sat idle waiting for sign-off treats the cause.

A review process that feels thorough is not the same as one that protects your launch date. Rounds of feedback measure activity. Time-to-launch measures whether any of it worked.

Once you measure waiting instead of effort, the next question answers itself. Why is the project waiting at all? Most of the time, the answer is that review is improvised from scratch every single time.

Treat review as a system, not something you rebuild every project

Review cycles stall because they are reinvented on each project. A new redesign starts a new email thread, a new and undocumented order of approvers, and a new scramble to figure out who has the final say. Nothing carries over, so the same delays repeat. The fix is to make review a repeatable system that runs the same way every time, the way good brand work is a system, not a one-off project.

A working system has a few fixed parts. The brief is locked and signed off before any design begins, because a vague brief is the single most reliable predictor of extra revision rounds. Every stage has one named owner, so nobody can assume someone else is handling it. Feedback lands in one place, gets consolidated, and reaches the designer as a single deduplicated set of instructions instead of five contradictory email chains. Rounds are capped per stage, and each reviewer has a clear turnaround time. Content readiness is part of the plan from day one, which is where a real content strategy earns its keep, since missing copy is one of the most common reasons a launch slips.

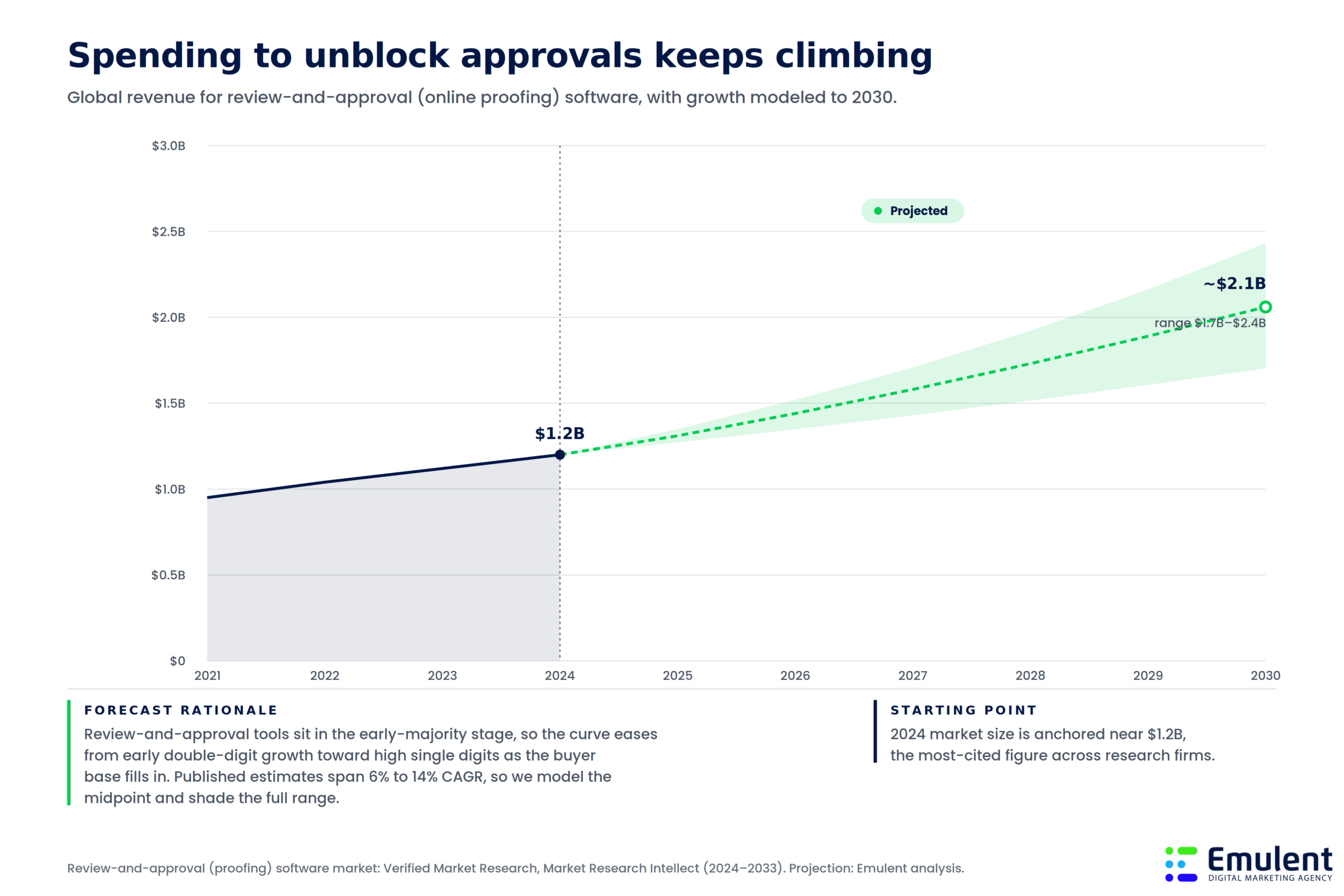

Area Chart Showing Global Revenue For Review-And-Approval (Proofing) Software Climbing From About 1.2 Billion Dollars In 2024 Toward Roughly 2.1 Billion Dollars By 2030.

Teams clearly feel this pain, because spending on review-and-approval software keeps climbing as organizations try to unblock their sign-off process. Tools can hold the queue, route work, and consolidate comments, and that helps. The structure has to come first, though. A tool laid over an improvised process just makes the chaos faster.

Buying review software before you have a review system is like buying a faster car before you have a map. You will reach the wrong place sooner.

A system decides how review runs. It does not, by itself, decide who gets to weigh in. That choice is where most timelines are quietly won or lost.

Decide who actually approves, and cap the rounds

The fastest way to slow a project is to let everyone approve it. Each added approver brings real cost: scheduling, a fresh set of comments, and another point where the work can sit untouched. The discipline that keeps projects moving is the willingness to say no, the same discipline that a sharp brand strategy should help you say no with. Many people can give input. Very few should hold sign-off. Drawing that line, and naming exactly who approves at each stage, removes most of the stalling before it starts.

Two more limits help. Cap the revision rounds per stage so feedback cannot cycle forever, and park scope creep instead of absorbing it. The week-eight request to “also add a booking widget” does not have to derail the launch. It goes onto a phase two list, and the current scope ships. Protecting the original scope is how you protect the date.

Grouped Bar Chart Showing Weeks To Launch Rising With The Number Of Reviewers, Where Email Sign-Off Climbs From 7 Weeks At One Reviewer To 15 Weeks At Seven, While A Structured Queue Stays Much Tighter.

The cost of extra approvers is not abstract. Modeled against a normal redesign baseline, a single reviewer signing off through a structured queue can wrap in about six weeks. Push that to seven approvers passing files around by email, and the same project can run past fifteen weeks before launch. The number of people and the way they review are doing more to your timeline than the design ever did.

Input is cheap and welcome. Approval is expensive and should be rare. Confuse the two and your launch date pays for it.

Limiting approvers solves the part of the problem inside your own building. There is a wider truth worth naming, though: across almost every stalled project, the delay sits on the client side, not the designer side.

Own your review window, because the delay is usually on your side

It is easy to assume a late website is a slow agency. Far more often, the designer is ready and the project is sitting in a shared folder, waiting for a decision that nobody has blocked time to make. Marketing assumes legal is reviewing it. Legal assumes brand already approved. The page sits, and the launch window slips past. The single most useful thing a client can do is treat the review window as their own responsibility, not the agency’s.

Owning it is concrete. Name one decision-maker who can give the final yes, so feedback does not splinter across a committee. Block real calendar time during the review weeks, the same way you would protect time for a launch event, so review is scheduled work rather than something squeezed in late. Set a clear turnaround of three to five business days per round and hold to it. Get content ready early, because copy is the quiet time-sink that derails more launches than design ever does. A simple website redesign checklist can lock these commitments in before kickoff, while everyone still has the goodwill to agree to them.

When you own the review window, the schedule stops depending on luck. That leaves one last source of false comfort to clear away, which is the belief that the right tool will solve all of this for you.

Be realistic about what tools and AI can fix

Software helps, and it is worth using. Review-and-approval tools consolidate feedback, route work to the right reviewer, and cut the idle time between rounds. Automation can save a few hours a week of chasing comments. None of that removes the actual bottleneck, which is a person making a decision. A tool can put the choice in front of the right reviewer faster. It cannot make the reviewer choose. AI can cluster duplicate comments and flag conflicts, and that is genuinely useful, but the judgment call still belongs to a human, and that is where the days go.

Line Chart Showing The Share Of Us Marketing Teams Using Review-And-Approval Tools Rising From 52 Percent In 2020 To About 74 Percent In 2024 And Flattening Toward A Practical Ceiling Near 90 Percent By 2030.

There is also a ceiling worth seeing clearly. Most US marketing teams already use review-and-approval tools, and adoption is bending toward saturation rather than climbing the way it did a few years ago. The plain reading is that the easy gains from “just buy a tool” are mostly spent. If your peers already have the software and still miss launch dates, more software is not the missing piece. The remaining gains come from the decisions, the ownership, and the limits you set, not from the next purchase. Keeping a clear head about this is part of reading web design trends honestly rather than chasing them.

A tool can deliver the decision to the right desk in seconds. It still cannot make the decision. That gap is where your timeline lives.

Put the five together and the picture is simple, and very different from “review harder.”

Where this leaves you

Faster launches do not come from more careful-feeling review. They come from measuring time-to-launch instead of round counts, running review as a repeatable system, limiting who approves, owning your own review window, and being honest about what tools can and cannot fix. Each one removes waiting, and waiting is where the weeks go. None of it requires a bigger budget or a faster design team. It requires clearer decisions and the discipline to protect them.

If your website projects keep slipping in review, that is the part worth fixing first, and it is usually quicker to fix than people expect. Talk through your review process with us and we will help you find where the weeks are actually disappearing.
